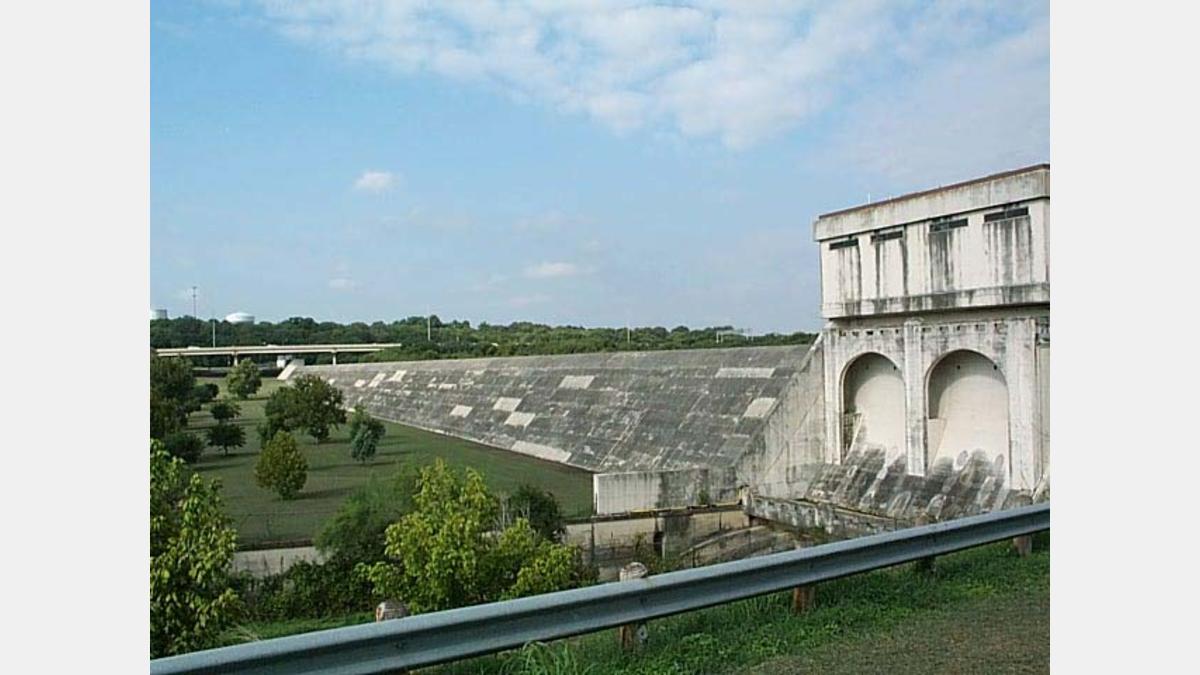

Olmos Dam was originally constructed in 1925-1927 as part of the City of San Antonio’s early efforts to effectuate a flood control plan for San Antonio at a cost of $1.5 million.

In 1973-1974 the city hired Hensley-Schmidt, Inc., Consulting Engineers, to investigate the structural integrity, stability and carrying capacity of the dam. The findings indicated th at the reservoir would contain a 200-year frequency flood but had stability and erosion problems if tested under certain storm conditions. Modifications to the structure were therefore recommended.

In 1976, the City of San Antonio secured federal participation from the Economic Development Administration (EDA), and the mayor appointed an Olmos Dam task force to provide citizen and organization input to help define the criteria to incorporate into the project.

On completion of the Task Force recommendations and engineering plans, the San Antonio River Authority, as project participant and construction coordinator, bid and awarded the construction contract to Clearwater Constructors, Inc., in March 1979. The project included strengthening and anchoring the dam, modifying the gate operations, providing an emergency spillway, relocating Olmos Drive, providing a pedestrian walkway, and improving Devine Road for a total cost of approximately $10 million.

A subsequent contract was awarded to Hogan Mechanical, Inc., in January 1989. The contract consisted of replacing the original gate hoist operators with new Limitorque operators and controls and installing monitoring instrumentation and controls for these gate operators at the Nueva Street Control Center at a total cost of $335,000.

The gates of Olmos Dam can now be monitored and/or controlled from the Nueva St. Dam Control Room.

past-projects-sar_olmos-dam-3

Project Details:

Share:

Facebook
Twitter
LinkedIn
Email

Related Projects

Sheridan Building Proposed Rendering

Facilities Design & Construction

This project involves the planning, design, and construction of a new facility at 201 W. Sheridan, aimed at supporting the River Authority's long-term operational and…

Parks Design and Construction

This project involves the design and construction of River Authority owned nature-based parks along the Medina River and San Antonio River. It aims to expand…

Edwards Aquifer Watershed Protection

This project is managed and administered by the River Authority for the City of San Antonio’s Proposition 1-funded Edwards Aquifer Protection Program. It supports water…

Alerts

Escondido Creek Parkway Playground Closure

The playground at Escondido Creek Parkway will be temporarily closed from July 31 through August 2 for maintenance and is scheduled to reopen on Monday, August 3.

We appreciate your patience and understanding

SASPAMCO Paddling Trail Temporarily Closed

Staff have removed two large log jams just downstream of Helton Nature Park, keeping the southern portion of the SASPAMCO Paddling Trail temporarily closed. Staff are working to contact adjacent landowners to support a land-based removal solution.

Goliad Paddling Trail Alert

NOTICE: HWY 59 Landing Site Closed

Due to TxDOT construction on the HWY 59 Bridge, the HWY 59 landing site is closed until further notice. However, the Goliad Paddling Trail remains open, and paddlers can still access the river at the Riverdale, Ferry Street, and Goliad State Park landings.

Please plan accordingly and check back for updates.

River Reach Newsletter and Blog Signup

River Reach is offered as a printed, physical mailing to your residence or business. The Blog is a weekly electronic email with news and updates in order to be more environmentally conscious. Please fill out the form below and indicate your preferred method of delivery.

By submitting this form, you are consenting to receive marketing materials from: San Antonio River Authority, 100 East Guenther St., San Antonio, TX, 78204, US. You can revoke your consent to receive emails at any time by using the SafeUnsubscribe® link, found at the bottom of every email. Emails are serviced by Constant Contact. This site is protected by reCAPTCHA and the Google Privacy Policy and Terms of Service apply.
